When does construction start and how long will it last?
Work begins in February 2026 and is scheduled to finish in February 2028.
Why two years?
This project combines work that might normally occur over several projects into one coordinated effort.

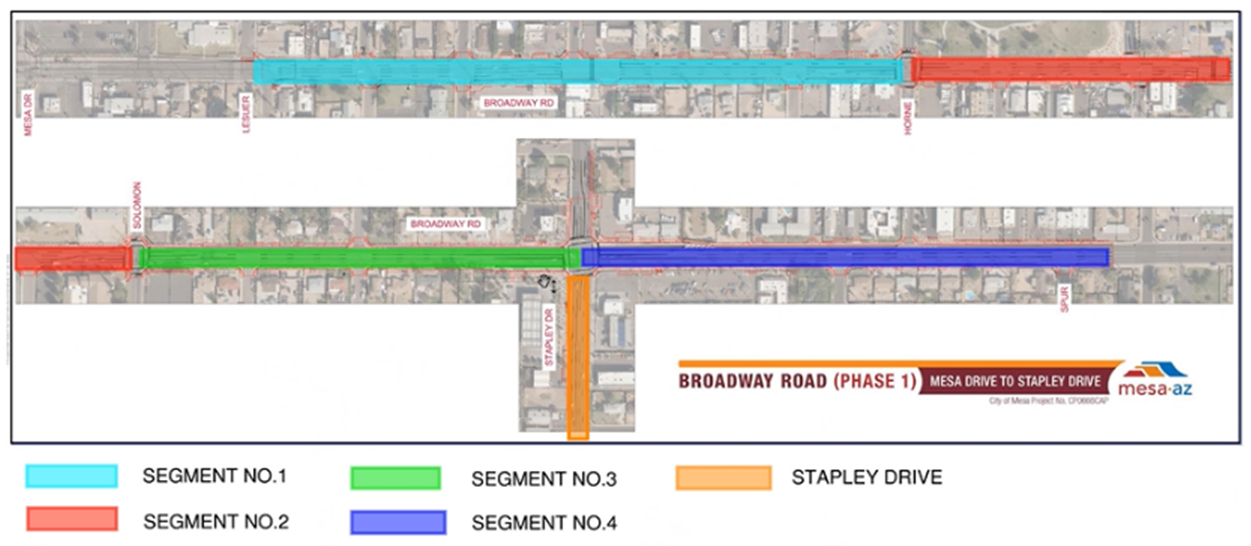

Feb – Dec 2026: Underground utility work, with traffic changes as work moves by block and overlaps between phases.
Jan – Dec 2027: Roadway reconstruction, including curbs, sidewalks, signals, lighting, and concrete.
Jan – Feb 2028: Striping, landscaping, and final roadway features.
